Financial position, transactions and runway

Keep ceiling, obligations, incurred, invoiced and paid distinct; reconcile deduplicated transactions; forecast funding runway (FN01–FN03).

Budget analyst · Contracting Officer · COR

/pdcc/acquisitions/contracts/CT-DEMO-007/financials
Live walkthrough · Financial position, transactions and runway
/pdcc/acquisitions/contracts/CT-DEMO-007/financials
/pdcc/acquisitions/contracts/CT-DEMO-007/transactions
/pdcc/acquisitions/contracts/CT-DEMO-007/runway
/pdcc/acquisitions/contracts/CT-DEMO-007/deobligation

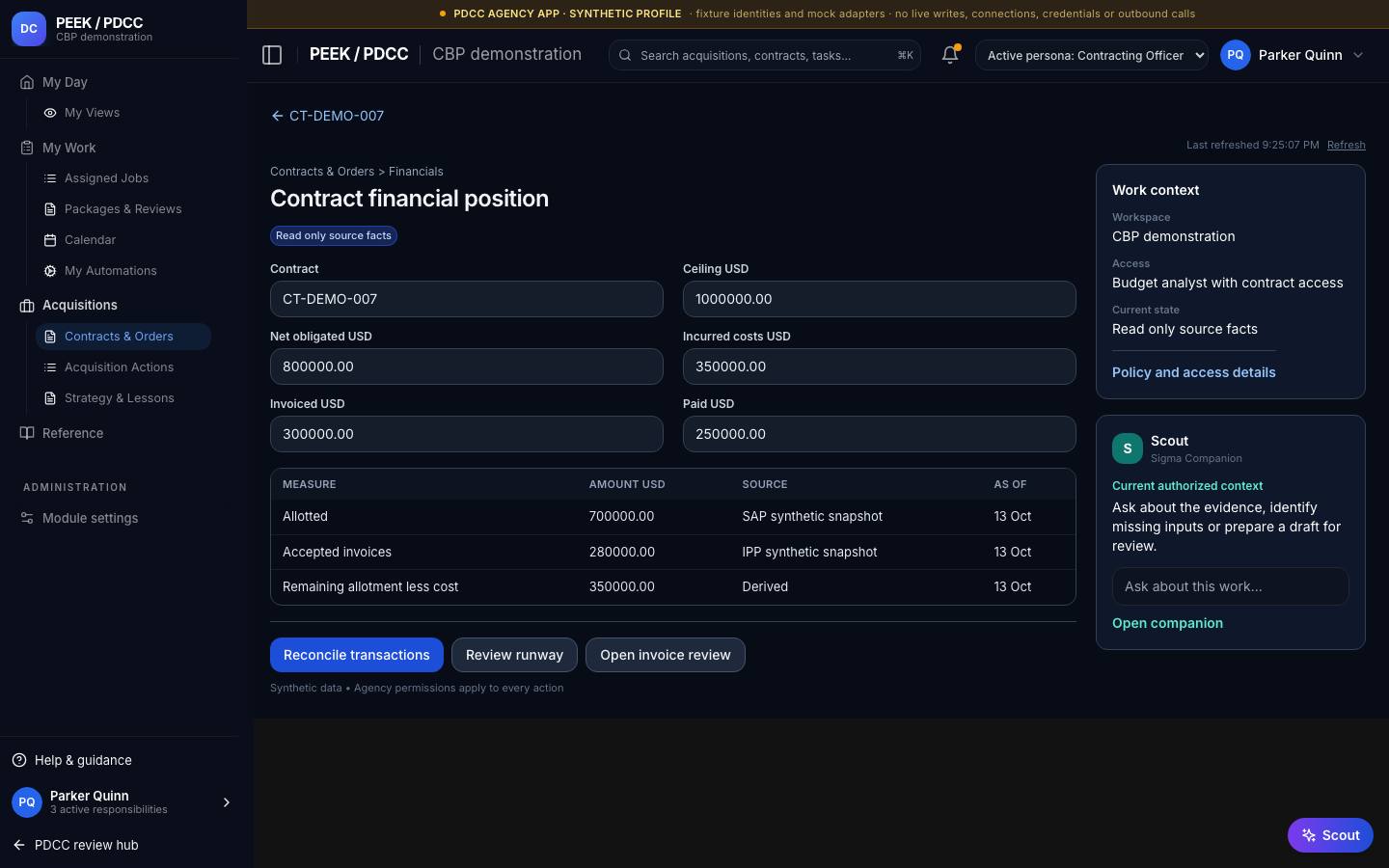

Contract financial position (FN01)

MeasureExample (USD)Notes
Ceiling1,000,000.00Maximum value; not funding.
Net obligated800,000.00Sum of deduplicated obligations.
Incurred costs350,000.00Contractor-reported cost.
Invoiced300,000.00Overlaps incurred.
Paid250,000.00From the payment source.
Heads up — Invoiced and incurred overlap — never add 300,000 to 350,000 as total cost. Ceiling, obligations and allotments are not interchangeable.

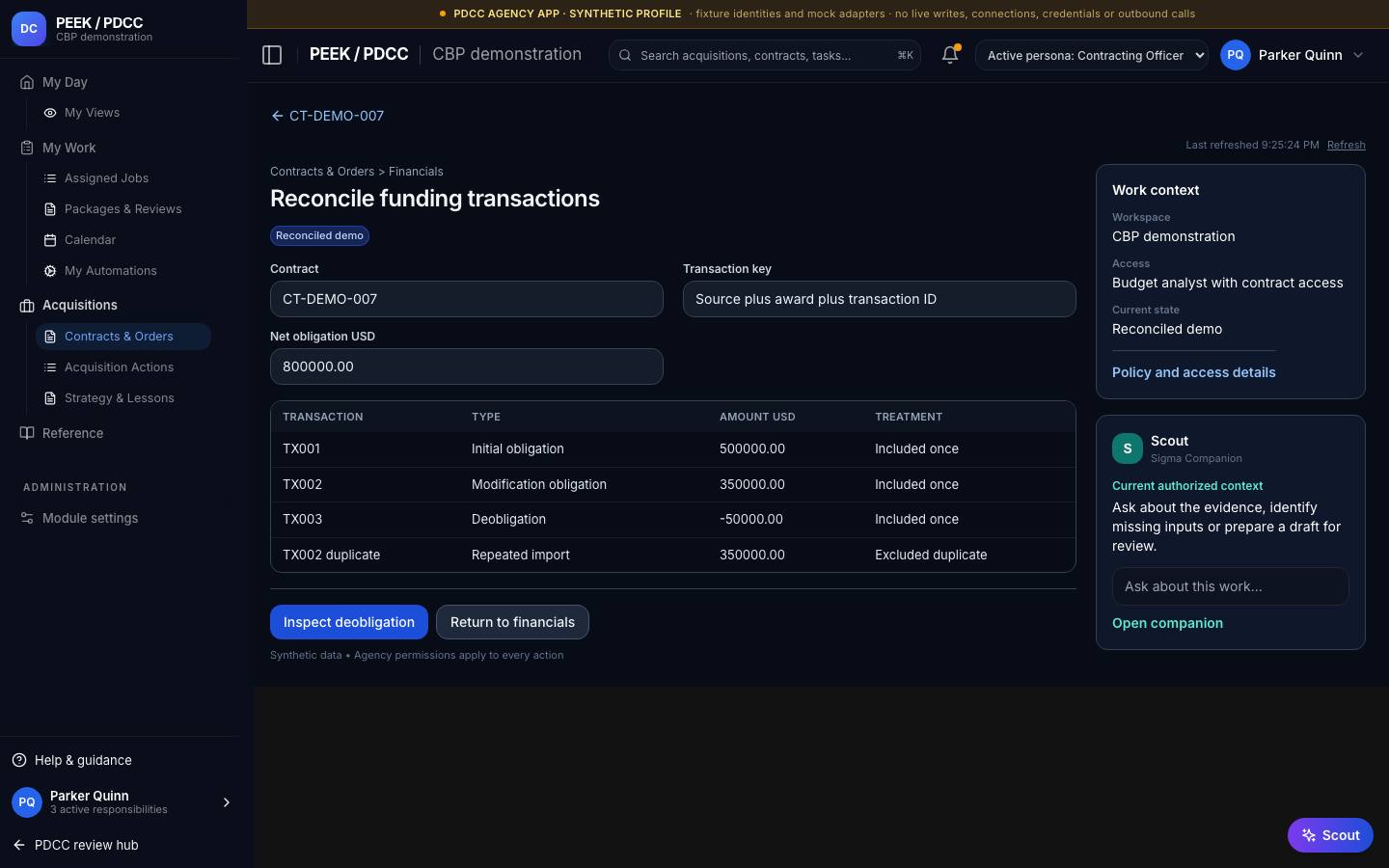

Reconcile transactions (FN02)

Transactions are deduplicated by source + award + transaction ID; corrections are preserved. Negative funding (e.g. TX003 deobligation) does not prove poor planning or poor contractor performance.

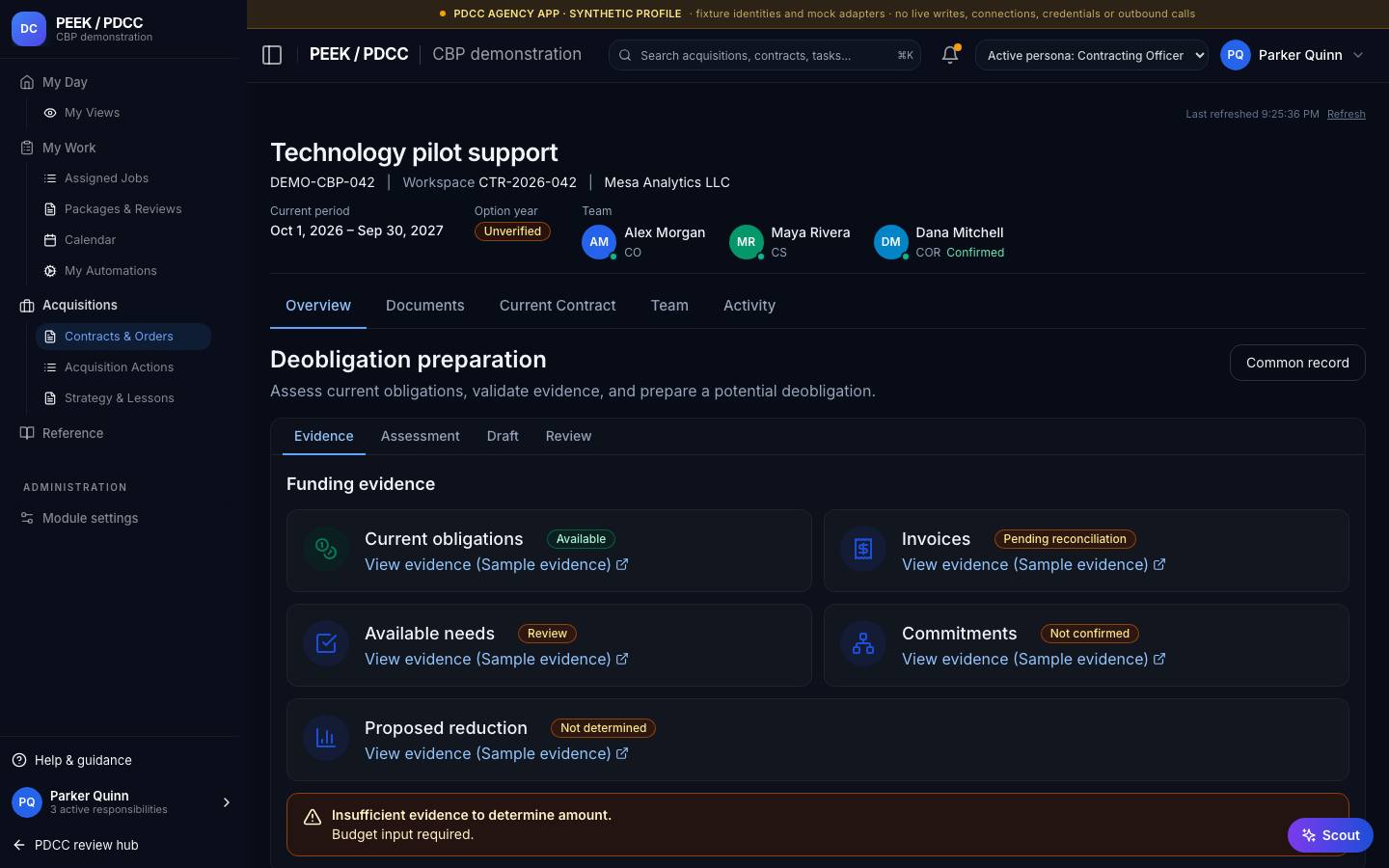

Deobligation evidence assessment

Computes *no available reduction* until reconciled evidence supports one. Preparation cannot release or obligate funds.

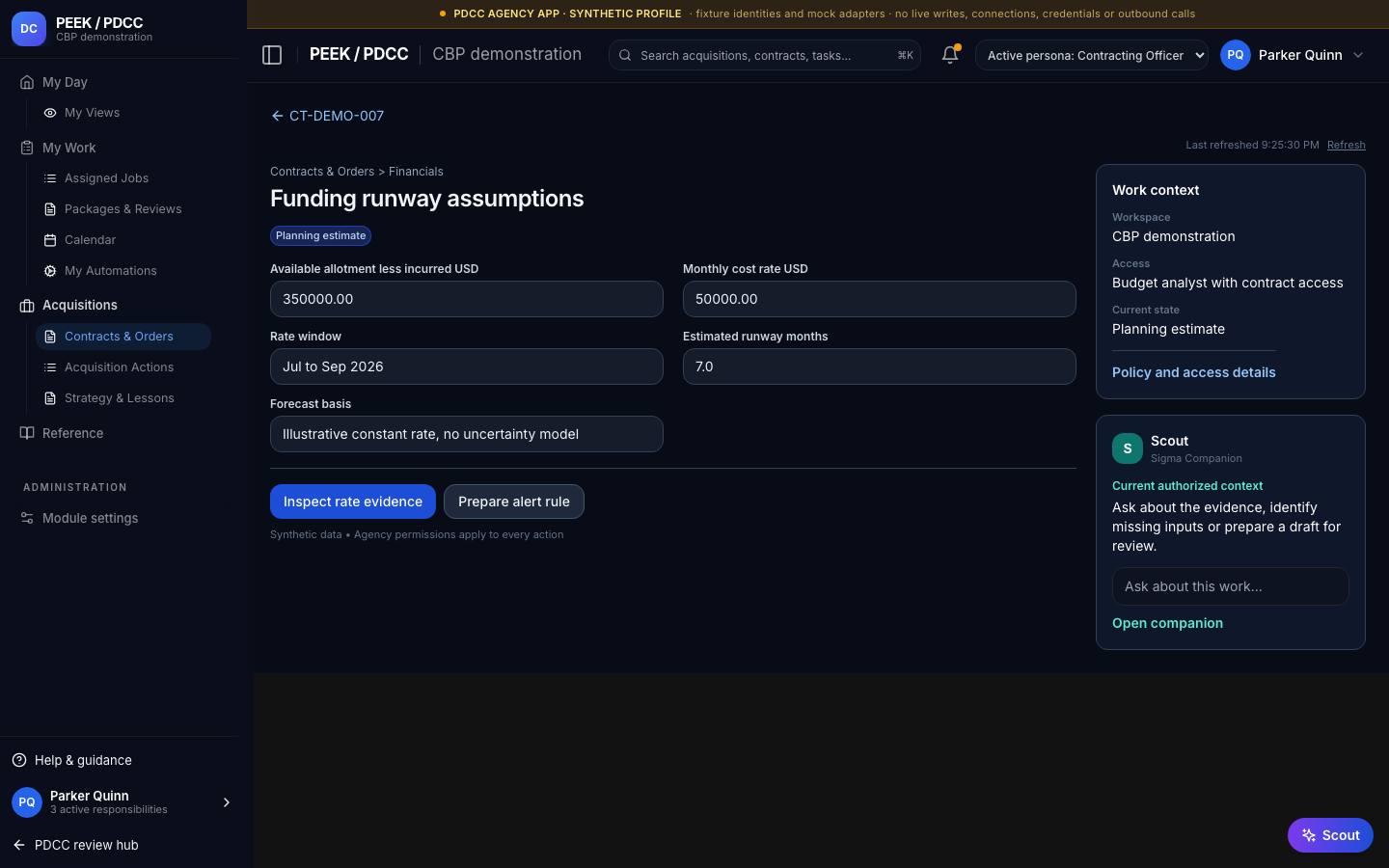

Funding runway (FN03)

Available allotment less incurred
e.g. 350,000.00.
Monthly cost rate
e.g. 50,000.00 over a named rate window (Jul–Sep 2026).
Estimated runway months
Remaining relevant funding ÷ positive cost rate = 7.0.
Forecast basis
e.g. illustrative constant rate, no uncertainty model.
Note — Missing, stale or non-comparable costs make the runway unavailable, not a precise number.
